Lead status and lead stages

The difference between a lead's status and its stage, the default lead pipeline, how to move a lead between stages, and how admins set stages up.

Updated 9 October 2026 · 6 min read

Every lead has a status and a stage. They tell you different things, and you change each one on its own.

StatusStage
Tells youHave you reached this person yet?How close is this lead to buying?
ValuesA fixed list of 8Your company's lead pipeline. An admin sets it up
Change it fromThe status dropdown, By Status in Kanban, or the edit formThe stage bar on the lead page, or By Stage in Kanban
RulesYou can go from any status to any otherOnly the moves your pipeline allows. Some ask for fields or a reason

Statuses

StatusUse it when
Pre QualifiedThe lead is new and nobody has looked at it yet. Every new lead starts here
Not ContactedSomeone has looked at it, but nobody has reached out
Attempted to ContactYou tried to reach them and didn't get through
ContactedYou have spoken to them
Contact in FutureThey asked you to come back later
Not QualifiedThey aren't a fit right now
Junk LeadThe details are spam, fake or a test
Lost LeadThey decided not to go ahead

The Open Leads view shows leads that are Pre Qualified, Not Contacted, Attempted to Contact or Contact in Future.

Stages

Each stage is in one of three categories: Open, Closed Won or Closed Lost. Every company starts with the pipeline below. An admin can change it.

StageCategoryCan move to
NewOpenContacted, Disqualified
ContactedOpenEngaged, Meeting Scheduled, Disqualified, Lost
EngagedOpenMeeting Scheduled, Qualified, Disqualified, Lost
Meeting ScheduledOpenMeeting Completed, Disqualified, Lost
Meeting CompletedOpenQualified, Disqualified, Lost
QualifiedOpenConverted, Disqualified, Lost
ConvertedClosed Won
DisqualifiedClosed Lost
LostClosed Lost

A new lead starts in the first Open stage. That's New, unless your admin has changed the order.

When you move a lead to Disqualified or Lost, you pick a reason:

DisqualifiedLost
No BudgetChose Competitor
Wrong IndustryNo Response
Duplicate LeadProject Cancelled
Invalid Contact InfoTiming Not Right
Not Decision MakerPrice Too High
Other (type your own)Other (type your own)
Warning

To convert a lead, use the Convert button. Moving it to the Converted stage only changes its stage. It doesn't create a contact, account or deal. See Convert a lead.

Change a lead's stage

  1. Open the lead and click a stage on the stage bar. Or, on the leads list, switch to Kanban View > By Stage and drag the card.
  2. In Stage Change Confirmation, pick a reason if the stage asks for one. You can also choose Other and type your own.
  3. Add notes if you want, then confirm.

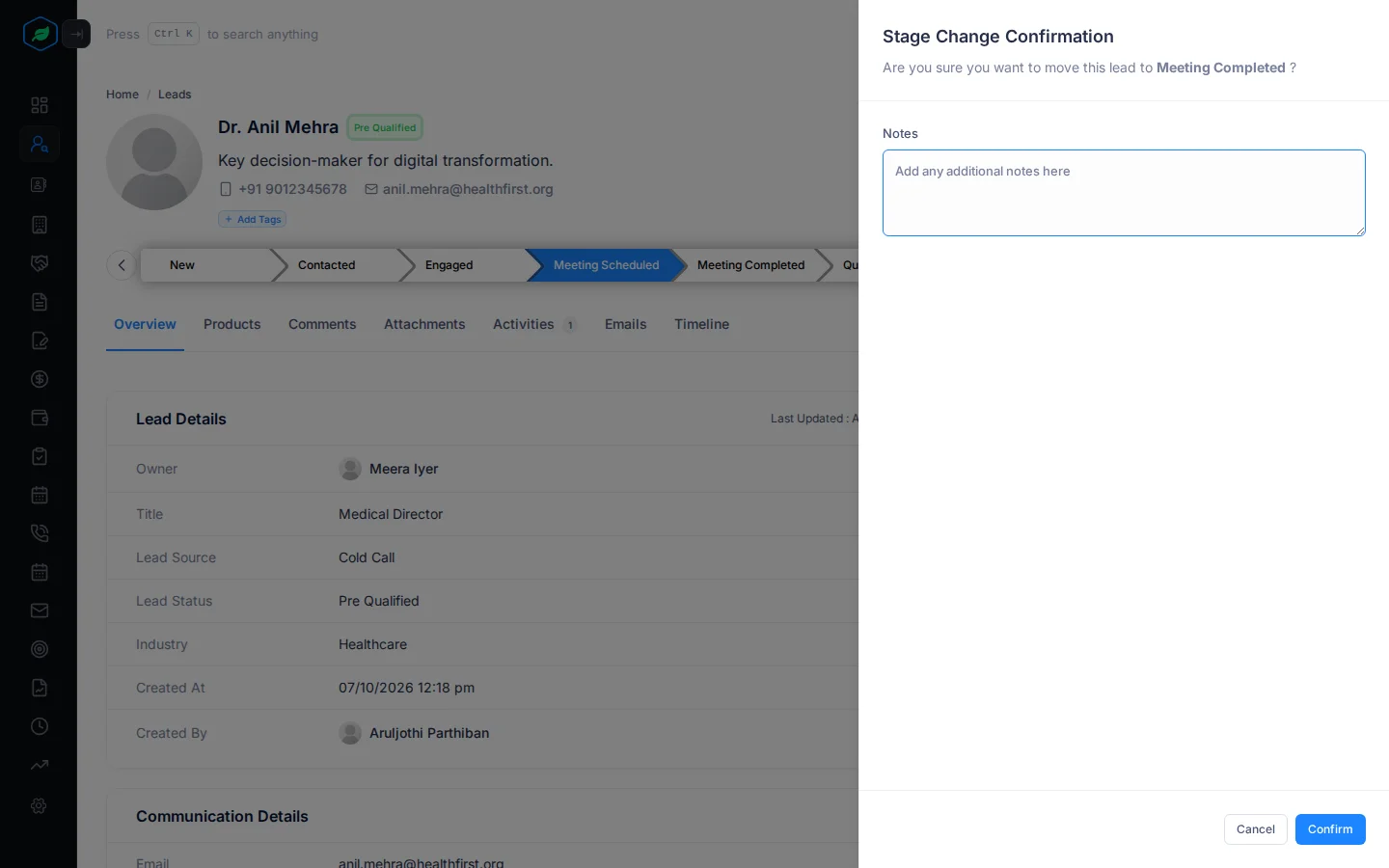

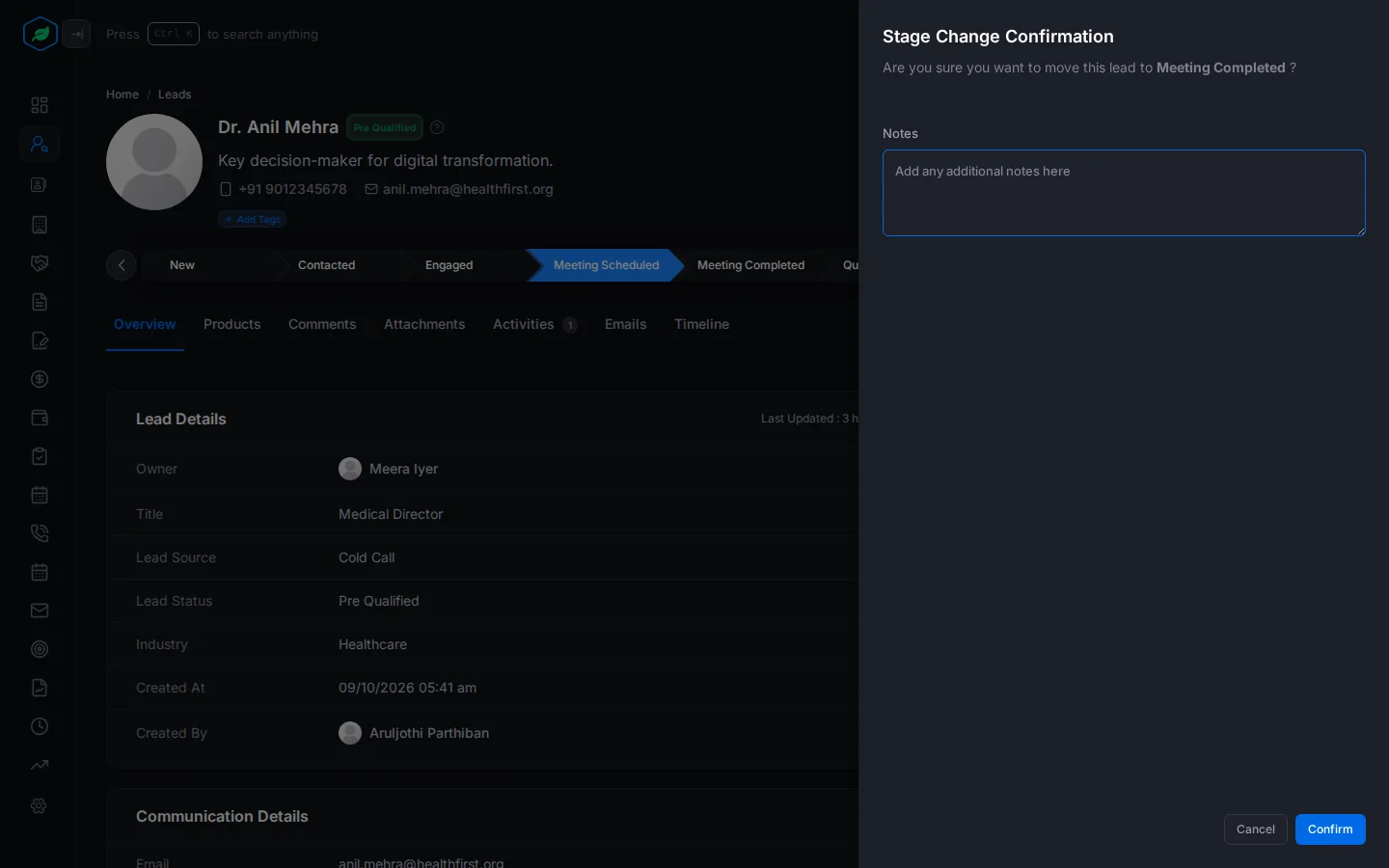

The Stage Change Confirmation panel asking to confirm the move to the next stage, with a Notes box

The move, the reason and your notes are saved on the lead's timeline.

You can change a lead's stage if you own it or created it, and it isn't locked, converted or a draft.

What can happen automatically

Your admin may have set up some automation on stages:

  • Stage automation rules: when a lead moves into a stage, this can create a task or a meeting, or send an email.
  • Max duration: if a lead stays in a stage longer than the time set, its owner gets a high-priority task named "SLA Breached".
  • Fallback: if a lead sits in a stage for too many days, it moves back to a set stage with the note "Automatically moved from X to Y after N days of inactivity."

Set up stages (admins)

Go to Settings > Pipeline Settings > Lead Pipelines. You need the lead pipeline permissions. To add or edit stages, you also need a paid plan.

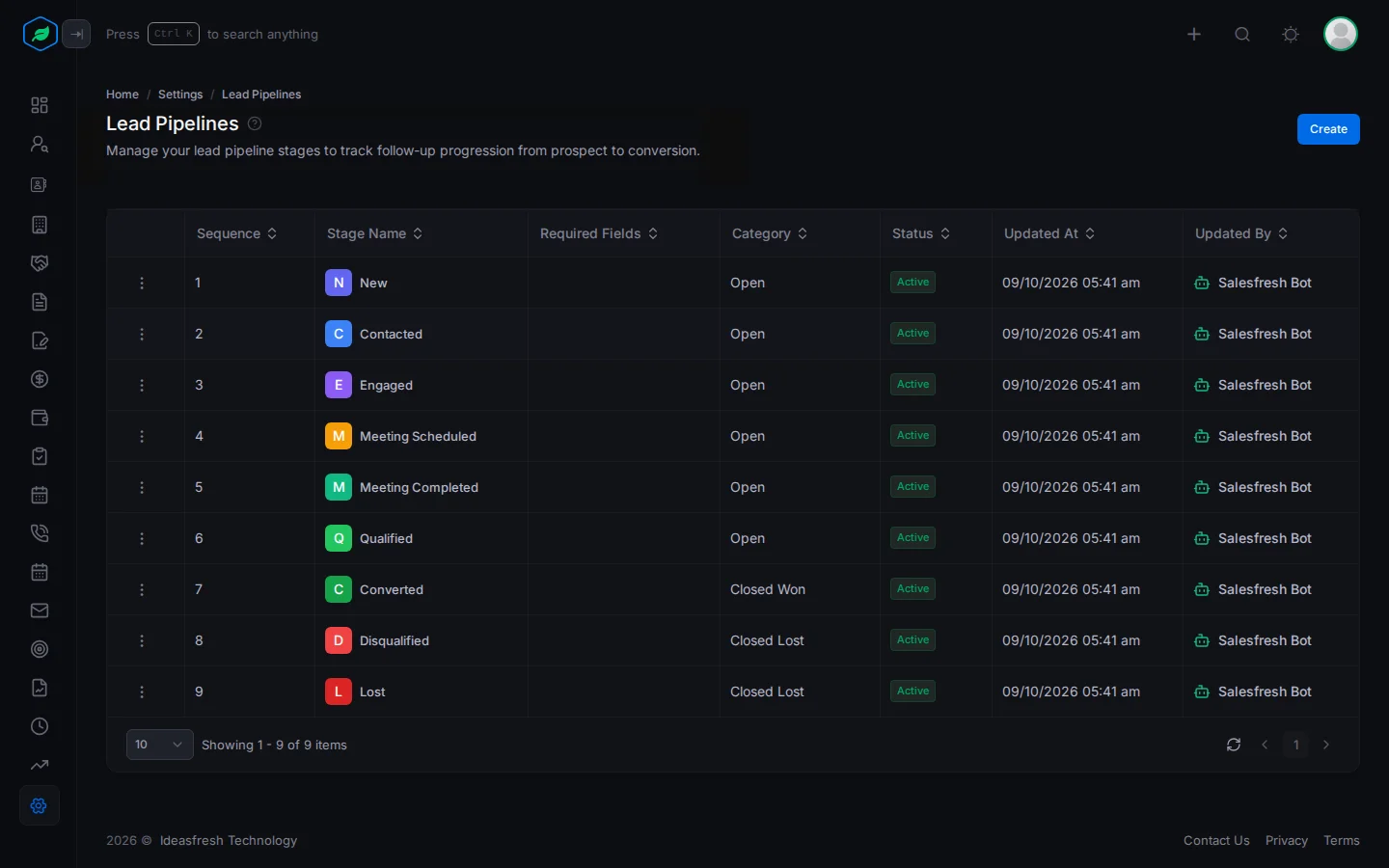

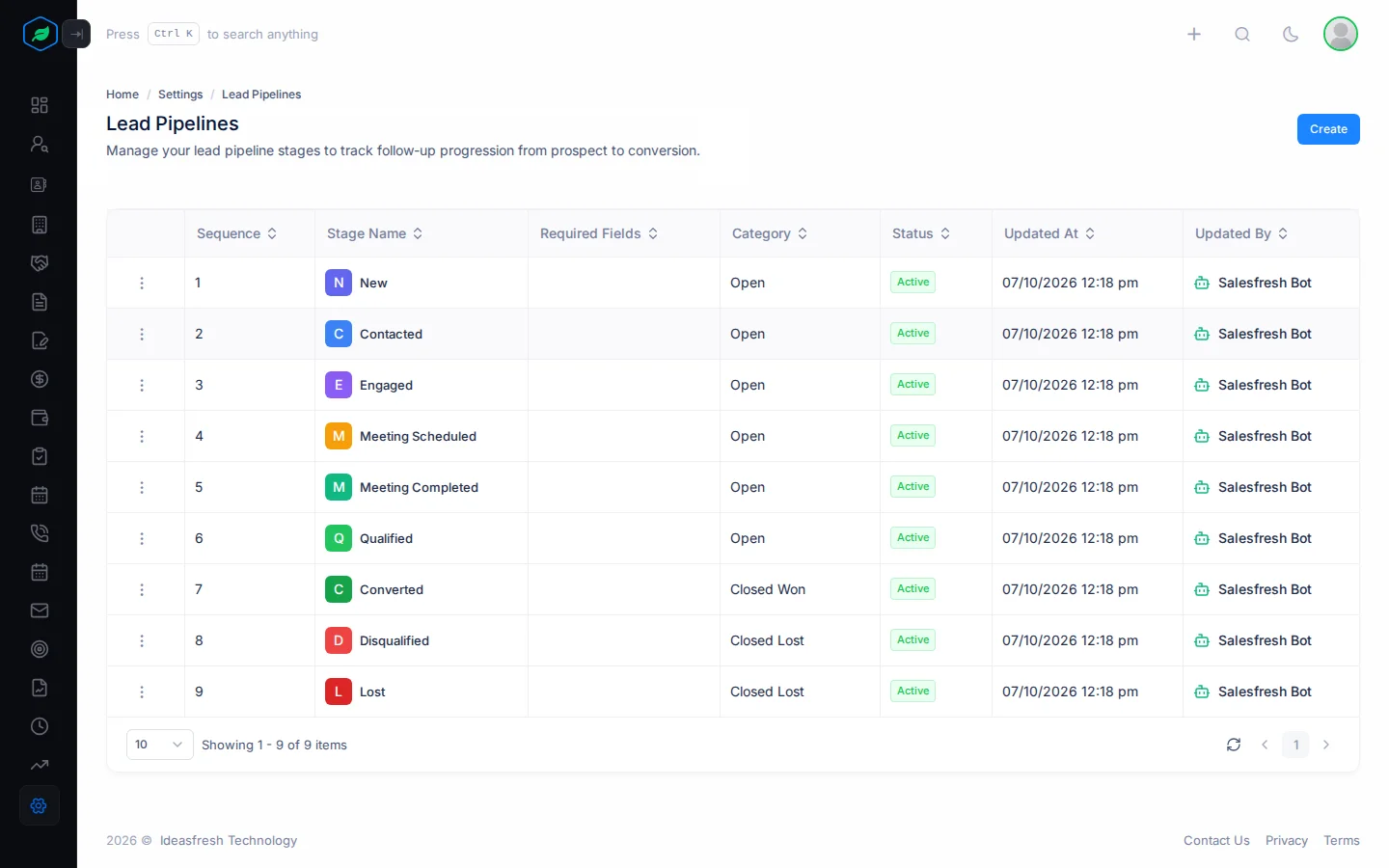

The Lead Pipelines settings page listing each stage with its sequence, category and status

SettingWhat it does
StageThe name. Up to 50 characters, and no two stages can share it
ColorThe colour of the stage's column on the Kanban board
SequenceWhere the stage sits in the pipeline, from 1 to 100
CategoryOpen, Closed Won or Closed Lost
Required FieldsLead fields that must be filled in before a lead can move into this stage
Max DurationHow long a lead should stay in this stage, in hours, days or weeks
Allowed TransitionsThe stages a lead can move to from here. Leave it empty to allow any stage
Transition ReasonsThe reasons you can pick when moving a lead. Each has a title and a description
Fallback Stage, Fallback After Days, Fallback ReasonWhere an idle lead goes, after how many days, and the reason saved with the move

Troubleshooting

You seeWhyWhat to do
"X to Y transition is not permitted by your pipeline."Your pipeline doesn't allow that moveMove the lead through a stage that is allowed, or ask an admin to allow the move
"Missing required fields for "Stage": …"The new stage needs fields this lead doesn't haveEdit the lead, fill in the fields listed, and try again
"A stage named 'X' already exists."Two stages can't have the same namePick another name
"A deleted stage named 'X' still holds this name. Edit that stage to bring it back."A deleted stage has this nameBring that stage back instead
"A stage cannot fall back to itself"You picked the same stage as its fallbackPick a different fallback stage
